Flat Slab Formwork System: Step-by-Step Site Execution Guide

7 min read 5 views
Flat Slab Formwork System: Step-by-Step Site Execution Guide

Flat slab formwork looks simple only from a distance; on site, a few millimeters of lost level can turn into visible soffit waves, extra grinding, delayed handover, and uncomfortable questions from the consultant.

The system is a temporary structure carrying fresh concrete, reinforcement, workers, vibration loads, and local construction traffic. Choosing reliable concrete formwork is therefore not a purchasing detail; it is an engineering decision affecting safety, surface quality, cycle time, and total project cost.


Five practical steps from drawing review to safe stripping of slab formwork.

Understanding the temporary structure behind a flat slab

A flat slab formwork system includes the contact surface, primary and secondary beams, adjustable props, heads, bracing, edge shutters, and small accessories that keep the whole arrangement stable. Each element has a job, and the system works only when the load path remains continuous from wet concrete down to the supporting floor.

For a 200 mm concrete slab, fresh concrete alone may weigh around 480 kg per square meter. Add reinforcement, workers, tools, formwork self-weight, and vibration effects, and the temporary load can reasonably move toward 600–750 kg per square meter. That is why prop spacing must never be guessed by habit.

When the slab is high, heavy, or irregular, the contractor should evaluate system scaffolding rather than relying on isolated props. A braced modular support tower can reduce sway, improve access, and provide a safer load-bearing arrangement.

Panels and concrete finish

The form face determines the slab soffit. Bent panels, swollen plywood, damaged edges, dirty surfaces, and excessive release oil all appear later as blemishes. If the ceiling remains exposed or receives thin finishing, these defects become immediately visible.

Steel panels offer high reuse potential, while plywood may be flexible for irregular zones. Polymer systems reduce handling weight. The right choice depends on repetition, moisture, required surface quality, labor skill, and the planned cycle time.

Props, heads, and vertical load transfer

Props are not just vertical tubes; they are compression members that must stand on sound bases, remain plumb, and connect correctly to heads or beams. A prop sitting on loose debris or soft ground can settle during pouring and create permanent deflection in the slab.

For ordinary building slabs, properly selected prop jacks for construction improve height adjustment and reduce unsafe improvisation. Damaged threads, missing pins, and unverified capacity should be rejected before installation.

Drawing review, grid lines, and level control

The work should start with drawings, not with panels. Structural drawings, architectural openings, MEP sleeves, drop zones, slab edges, column strips, and punching reinforcement details must be checked together before the first prop is installed.

A benchmark level should be transferred to columns or walls using a laser level or survey instrument. The formwork crew then adjusts props to that reference. If every bay is leveled by eye, the final soffit will not behave like one continuous plane.

A practical site routine is to check corner points, mid-span points, and column zones before reinforcement begins. A small correction of 3–5 mm is easy before rebar; after rebar, chairs, sleeves, and inspection tags are installed, the same correction becomes slow and expensive.

Openings and edge shutters

Shafts, ducts, stair openings, and sleeves must be marked on the form face with dimensions taken from coordinated drawings. A shifted opening may later require cutting reinforced concrete, exposing bars, delaying MEP trades, and weakening a carefully detailed zone.

Edge shutters need lateral support. Fresh concrete pressure and vibration can push an under-braced edge outward, leaving an uneven façade line or unwanted slab thickening. Good carpenters check edges twice: once before rebar and once just before pouring.

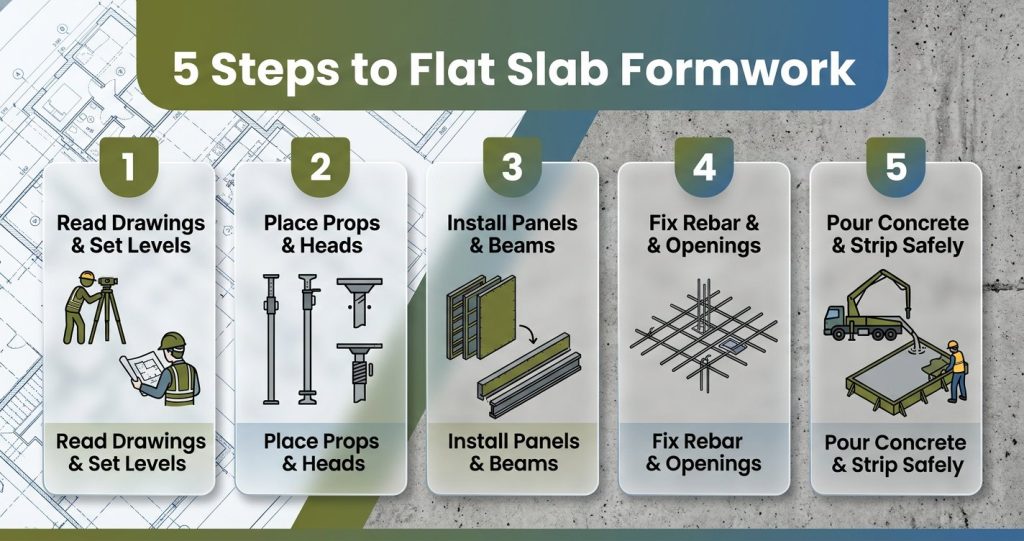

Step-by-step installation of props, beams, and deck panels

The usual sequence is simple: mark the grid, place props on stable sole plates, install primary beams, add secondary beams, place deck panels, close gaps, and complete edge formwork. The quality, however, depends on discipline. Skipping sequence makes alignment and load checking difficult.

Prop spacing depends on slab thickness, beam spacing, support height, formwork type, and allowable prop load. For common building slabs, spacing around 0.8–1.2 m may be seen, but the final arrangement must follow calculation, manufacturer recommendations, and site-specific safety requirements.

Tall props need bracing. During concrete vibration and worker movement, unbraced long props can sway or buckle. This risk grows in high floors, ramps, podium slabs, and areas where concrete is temporarily accumulated.

Primary and secondary beams

Primary beams collect loads from secondary beams and transfer them to props. Secondary beams reduce the free span of the form face. If a secondary beam is missing or too widely spaced, the deck can sag and the slab thickness can change during casting.

The site supervisor should inspect beam seating, alignment, bearing length, and loose members. A component that looks installed but does not bear properly is more dangerous than a missing component because it creates false confidence.

Checking level, locking props, and confirming the support line before reinforcement and concrete placement.

Reinforcement, final inspection, and concrete pouring

Before reinforcement, the deck should be clean, joints closed, release agent applied correctly, and loose materials removed. Too much release agent stains concrete and may affect local bonding conditions; too little makes stripping hard and damages panels.

Flat slabs are sensitive around columns, openings, and punching zones. If the formwork below these zones deflects, cover, effective depth, and reinforcement position are affected. That is not only a finishing issue; it can become a structural performance issue.

Concrete should be placed in a balanced pattern. Do not pile concrete in one location while waiting for workers to spread it. A local heap can overload deck panels and props even when the average slab load seems acceptable.

Technical comparison of slab formwork options

SystemWeight per m²Installation speedReuse potentialInitial costMain risk
Modular steel panelsMedium to highGood with trained crewHighMediumPoor leveling if rushed
Plywood deckMediumMediumLimited in moistureLow to mediumSwelling and edge damage
Polymer panelsLowHighMedium to highMediumMisuse under heavy load
Shoring scaffoldHighMediumHighMedium to highNeeds bracing plan
Hybrid systemVariableProject dependentVariableOptimizableRequires strong supervision

Stripping, quality control, and project economics

Stripping must follow concrete strength, temperature, span, curing conditions, and engineer approval. Removing supports too early may cause cracking, long-term deflection, or structural damage. Keeping equipment too long, however, slows the formwork cycle and increases capital cost.

The real cost of formwork includes purchase price, repair, cleaning, handling, storage, labor productivity, reuse cycles, and the cost of repairing concrete defects. A more expensive system can be cheaper over the whole project if it reduces rework and accelerates floor cycles.

TL;DR: lock the drawings, establish a reliable benchmark, calculate prop spacing, brace tall supports, inspect before rebar, pour concrete evenly, and strip only after strength is confirmed. These habits protect both the slab and the schedule.

FAQ

What is the usual prop spacing for a flat slab?
There is no universal spacing. It depends on slab thickness, formwork type, support height, prop capacity, and construction load. Common building projects may use 0.8–1.2 m, but calculation is required.
Can plywood be used for flat slabs?
Yes, if it is supported correctly, protected from moisture, and checked for deflection. Plywood is flexible for irregular shapes but usually has lower reuse life than quality steel systems.
What is the biggest site mistake?
Starting installation without coordinated drawings and reliable level control. The second common mistake is removing bracing because the system “looks stable”.
When should stripping begin?
Only after concrete strength, span conditions, curing temperature, and engineering instructions are checked. Partial reshoring may be required for long spans or fast construction cycles.
How can formwork cost be reduced?
Use a planned cycle, maintain panels, train crews, reduce cutting, coordinate openings early, and select a system with the right balance of speed, reuse, and surface quality.

Conclusion: flat slab formwork succeeds when design, equipment, and site supervision work together. A stable, clean, and well-leveled temporary structure produces a better permanent structure.
